Further delay in Finnish repository licence review

Radioactive waste management company Posiva submitted its application, together with related information, to the Ministry of Economic Affairs and Employment on 30 December 2021 for an operating licence for the used fuel encapsulation plant and final disposal facility currently under construction at Olkiluoto. The repository is expected to begin operations in the mid-2020s. Posiva is applying for an operating licence for a period from March 2024 to the end of 2070.

The government will make the final decision on Posiva’s application, but a positive opinion by the Radiation and Nuclear Safety Authority (STUK) is required beforehand. The regulator began its review in May 2022 after concluding Posiva had provided sufficient material. The ministry had requested STUK’s opinion on the application by the end of 2023. However, in January last year, STUK requested the deadline for its opinion be extended until the end of 2024. In December, the ministry extended the deadline for the regulator’s opinion to 31 December 2025.

The ministry has now extended the deadline until the end of June 2026, “if it is possible to do so by then”. According to STUK, the new timetable is possible, but tight, for both the authority and the licence applicant.

Although STUK’s assessment of the application is in the final stages, the statement and safety assessment cannot be completed until it has assessed and approved all of Posiva’s operating licence application materials.

“We have already received and approved most of Posiva’s operating permit application materials,” said STUK Project Manager Antti Tynkkynen. She said STUK has still made requests for clarification on the latest materials updated by Posiva, and expects to receive Posiva’s responses in early 2026.

“Overall, the processing of the operating licence application is close to completion, but delays have been caused by deficiencies in the documentation, updates due to plant modifications made by Posiva, and the scope of the updates,” STUK said in its latest quarterly report on its assessment. “In addition, STUK has identified uncertainties in the safety case review, the effects of which on long-term safety still need to be analysed.”

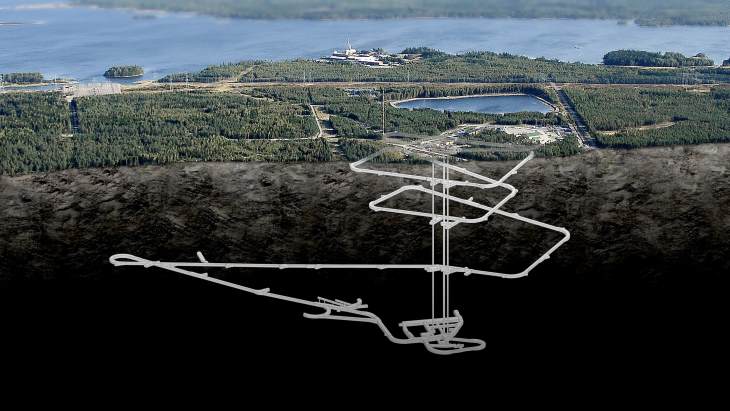

At the repository, used fuel will be placed in the bedrock, at a depth of about 430 metres. The disposal system consists of a tightly sealed iron-copper canister, a bentonite buffer enclosing the canister, a tunnel backfilling material made of swellable clay, the seal structures of the tunnels and premises, and the enclosing rock.

The government granted Posiva a construction licence for the project in November 2015 and construction work on the repository started in December 2016. Once it receives the operating licence, Posiva can start the final disposal of the used fuel generated from the operation of TVO’s Olkiluoto and Fortum’s Loviisa nuclear power plants. The operation will last for about 100 years before the repository is closed.

“Posiva’s project is the first in the world, so it understandably takes time to justify things and requires great care and expertise,” STUK said. “In particular, the demonstration of the performance of the clay material, which acts as one of the barriers to the spread of radioactive substances, is still under way. Posiva replaced the clay material in the original plans with another, and the effects of the new material on the long-term safety of the final disposal still need to be assessed.”



  • Related Posts

    NPCIL signs MoU for Gujarat nuclear power projects

    In what it called “a significant step towards exploring new horizons for nuclear power development in Gujarat”, Nuclear Power Corporation of India Limited (NPCIL) said the MoU would “facilitate collaboration between…

    Hinkley Point B becomes second AGR plant transferred for decommissioning

    Hinkley Point B – comprising two Advanced Gas-cooled Reactors (AGRs) – was first synchronised to the electricity grid in February 1976. The plant generated more than 311 terawatt-hours of electricity…

    Have You Seen?

    Japan’s JERA Creates Oil Storage Firm to Manage National Reserve Sites

    • October 2, 2026
    Japan’s JERA Creates Oil Storage Firm to Manage National Reserve Sites

    Alaska LNG Hinges on How Much Asian Buyers Will Pay for Energy Security

    • October 2, 2026
    Alaska LNG Hinges on How Much Asian Buyers Will Pay for Energy Security

    WTI Sinks Nearly 4% as EU Weighs Emergency Stockpile Release

    • October 2, 2026
    WTI Sinks Nearly 4% as EU Weighs Emergency Stockpile Release

    Latest Dallas Fed Survey Reveals Theme Among Respondents

    • October 2, 2026
    Latest Dallas Fed Survey Reveals Theme Among Respondents

    What is the near-term feasibility of helium-3 fuel for fusion power?

    • October 2, 2026
    What is the near-term feasibility of helium-3 fuel  for fusion power?

    UN Says Global Fuel Subsidies Could Top $1 Trillion

    • October 2, 2026
    UN Says Global Fuel Subsidies Could Top $1 Trillion

    JERA CEO Warns LNG Prices Have Further to Climb

    • October 2, 2026
    JERA CEO Warns LNG Prices Have Further to Climb

    Scaling up: Blue Star’s next phase in Colorado

    • October 2, 2026
    Scaling up: Blue Star’s next phase in Colorado

    Shougang, Rio Tinto commission carbon capture trial facility at China steel plant

    • October 2, 2026
    Shougang, Rio Tinto commission carbon capture trial facility at China steel plant

    Oil Prices Come Under Pressure

    • October 2, 2026
    Oil Prices Come Under Pressure
